We are announcing the status of major inspections and restoration works and
non conformances at TEPCO's Kashiwazaki-Kariwa Nuclear Power Station after
the Niigata-Chuetsu-Oki Earthquake.
Inspection/Restoration Status
 ◇ Inspection and restoration completed between August 27 to September 2, 2010
    (Completed on the following date)
   - Unit 3 Seismic reinforcement works (Seismic reinforcement works for reactor
     building overhead crane):
       August 27
 ◇ Inspection and restoration to be commenced between September 3 to September
    9, 2010
    (To be commenced on the following date)
   - No notable activity during this week
 ◇ Work Schedule of Major Inspection and Restoration from August 29 to
    September 25, 2010
   - Work Schedule of the Main Inspection/ Restoration of the Kashiwazaki-
     Kariwa Nuclear Power Station in Response to the Niigata-Chuetsu-Oki
     Earthquake (during 4 Weeks)                               ...Appendix
(Reference)
Nonconformances Found in the Inspection and Restoration Works Performed
after the Niigata-Chuetsu-Oki Earthquake
 Based on the "Public Announcement Regarding Nonconformance Found in the
 Inspection and Restoration Works Performed after the Niigata-Chuetsu-Oki
 Earthquake", the Tokyo Electric Power Company, Incorporated (TEPCO) provides
 this announcement containing incidents information reported from August 26
 to September 1, 2010.

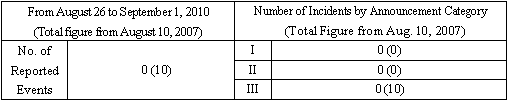

 ◇ Incidents Information (relating to the Chuetsu-Oki Earthquake)
 |   |

    <Reports from August 26 to September 1, 2010 >
 ◇ Other Findings
   - Nothing to disclose to this week.

Appendix: Work Schedule of the Main Inspection/Restoration of the Kashiwazaki-
          Kariwa Nuclear Power Station in Response to the Niigata-Chuetsu-Oki
          Earthquake (during 4 Weeks)(PDF 90.4KB)
